Introduction:
Mass maintenance is used to make make mass changes to master data such as materials, vendors, purchase orders, purchase requisitions, etc.
The full list of possible "objects" that can be changed are:
BUS0015 Profit center
BUS1001 Materials (industry)
BUS1001001 Materials (retail)
BUS1133 Rental units
BUS2012 Purchase orders
BUS2032 Sales orders
BUS2104 Appropriation reqs
BUS2105 Purchase requisition
BUS3003 Purchasing info recs
BUS3006 G/L accounts
KNA1 Customers
LFA1 Vendors
BUS0015 Profit center
BUS1001 Materials (industry)
BUS1001001 Materials (retail)
BUS1133 Rental units
BUS2012 Purchase orders
BUS2032 Sales orders
BUS2104 Appropriation reqs
BUS2105 Purchase requisition
BUS3003 Purchasing info recs
BUS3006 G/L accounts
KNA1 Customers
LFA1 Vendors
It is typically used by support staff to maintain / update master data. If your requirement is to complex for Mass Maintenance, then rather use LSMW, it can do even more -- but is more complex to use.
Summary of how the process works:
Run transaction MASS
- Select what master data element you want to change
- Select fields for selection and what will be changed
- Select master data to be changed
- Indicate what the new value is
- Save (Run)
For example: for all materials of type RAW1, make the material group 1012. Lets step through this example to show you how easy it is to use.
Running the transaction
SAP Menu: Logistics > Central Functions > Mass Maintenance > Mass Maintenance > Dialog Processing

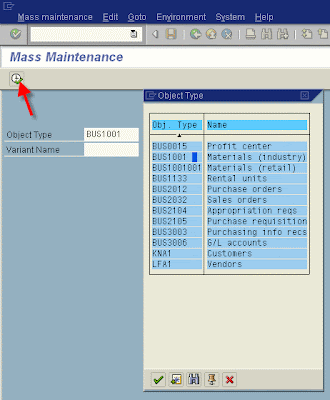

Transaction MASS

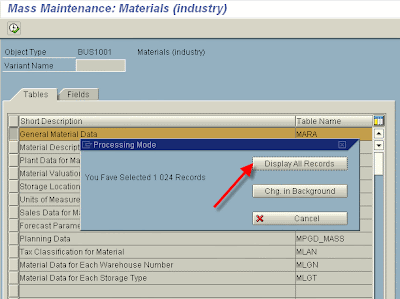

Select the tables for the selection screen. In our case, material type = MARA.

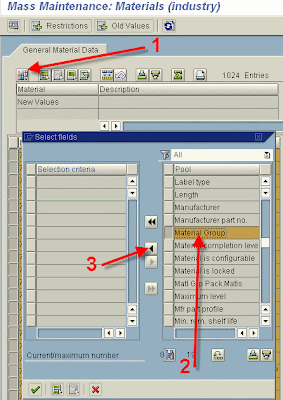

The materials selected will be listed.Now indicate which field must be change. In our example the material group field.
Enter what the new value (Material Group) must be.
Select the column and copy to all the materials listed below. If you don't want to change all objects -- unselect them at this point
Hit Save -- this will start the action to change the object (material)
A log will be displayed on if it was successful
6 comments:
Hi there,
Thanks for all the information provided on ur blog.
Now currently am stuck with OTD of my suppliers & ther are nos. of PO in which i need to change the delivery schedule can you pls guide me how can i change delivery date mentioned in the PO line by line using Mass maintenance.
Thanks
Afroz
The screen shots were very helpful in educating me!! thanks a million! unique presentation!!
Maintenance Job Description
Hi there,
i was thinking is there any t-code or ways that i will be able to mass upload attachment files to it's own document no.#? as i am now uploading one attachment file to one doc no.# via fb03-view document.
Please help me.. Too many to upload......
Anyone ever try another option available in screen shot #3 (Data Records to Be Created)?
Great place to learn new things and got the best SAP SD Training in Chennai
Very well written article. It will be helpful to anybody who employees it, as well as myself. Keep doing what you are doing – i will definitely read more posts.
Informatica IICS Training
Oracle Time and Labor Training
Post a Comment
